Midstream Infrastructure
Our gas midstream business will include gas gathering systems, processing, cryogenic systems to store NGLs and LNG for export and import.
Project Overview
Key Figures
Construction Phases
Phase A

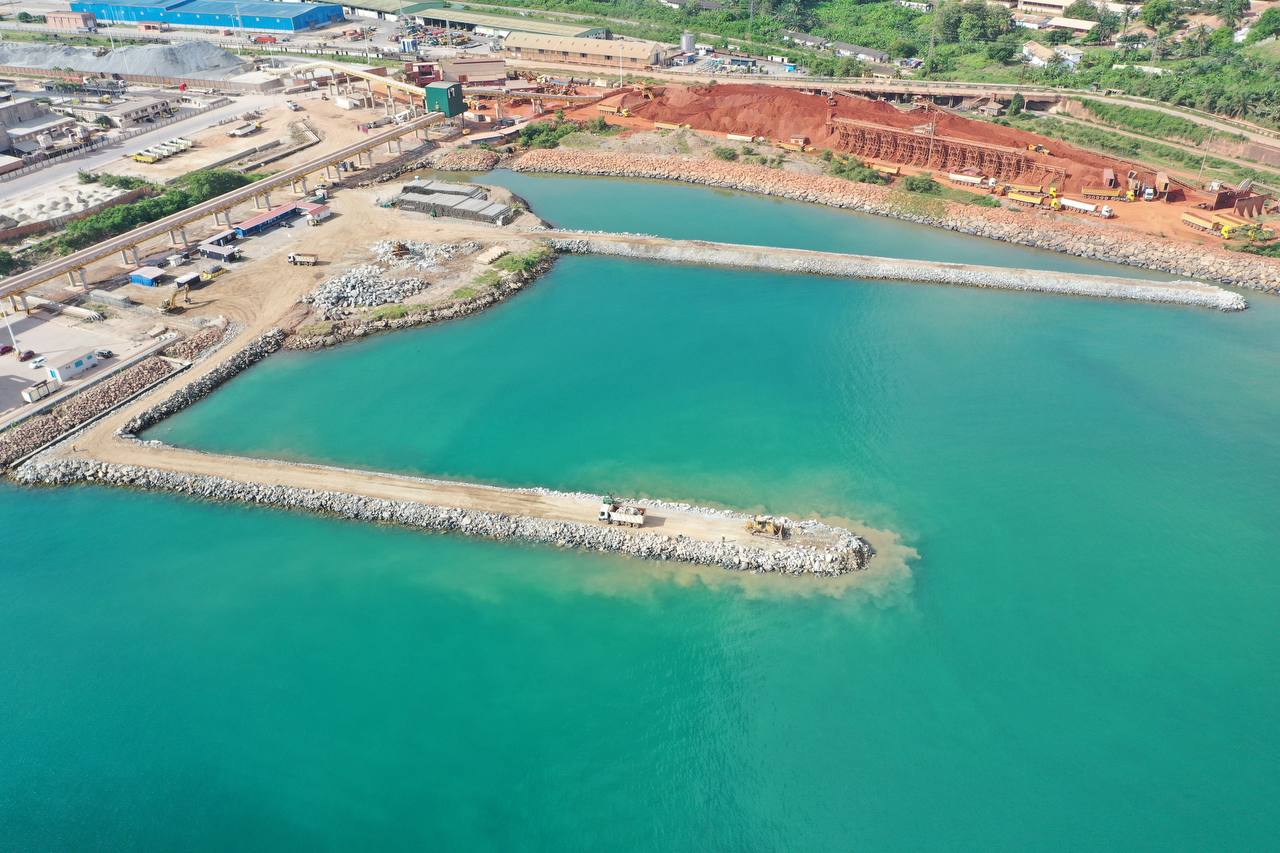

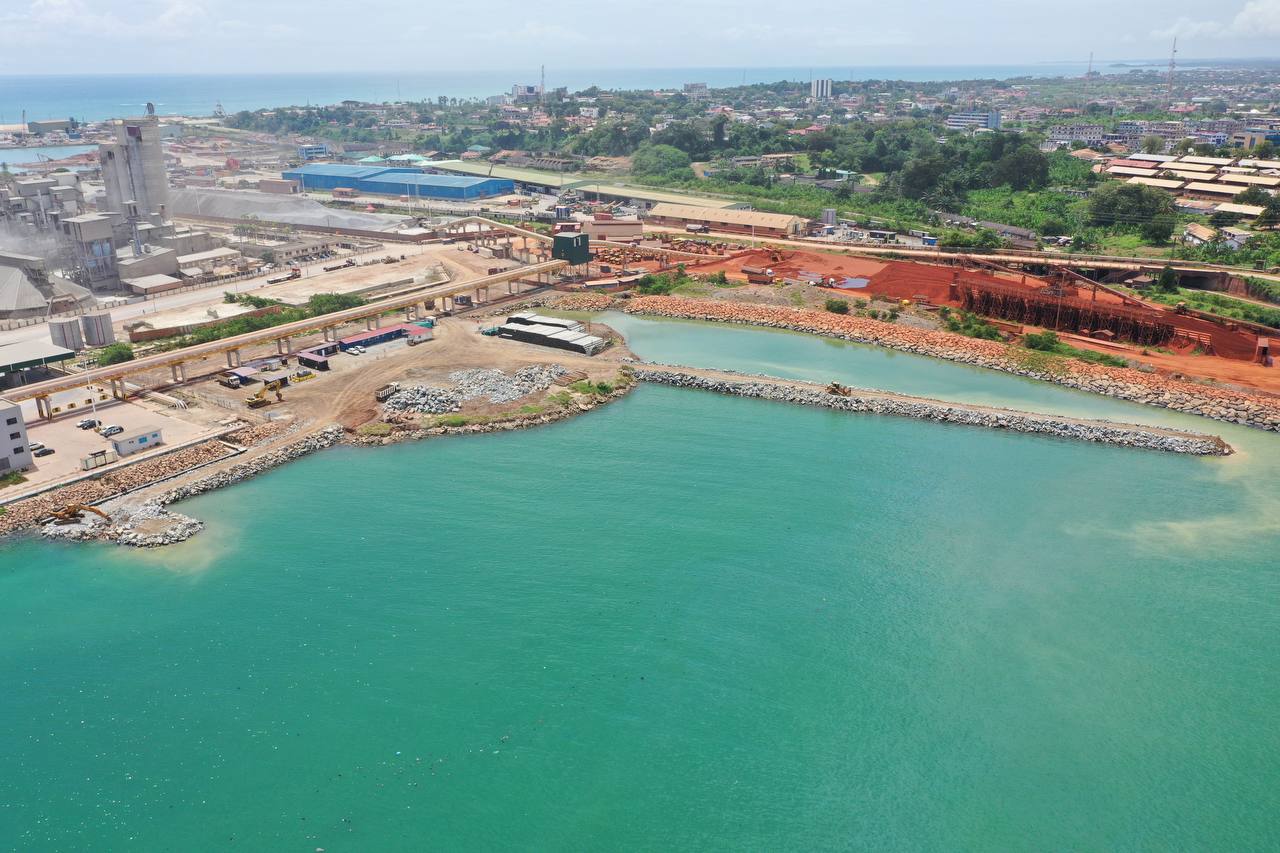

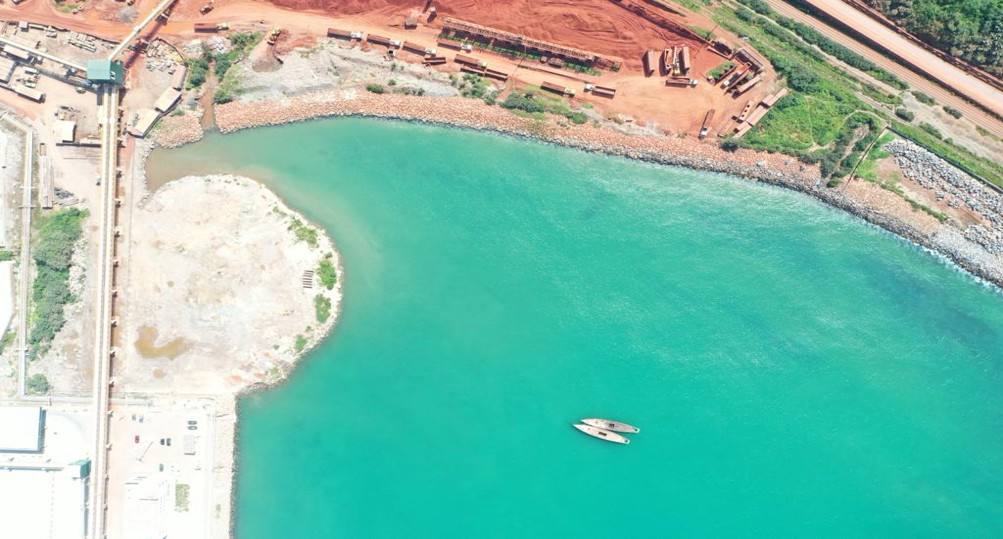

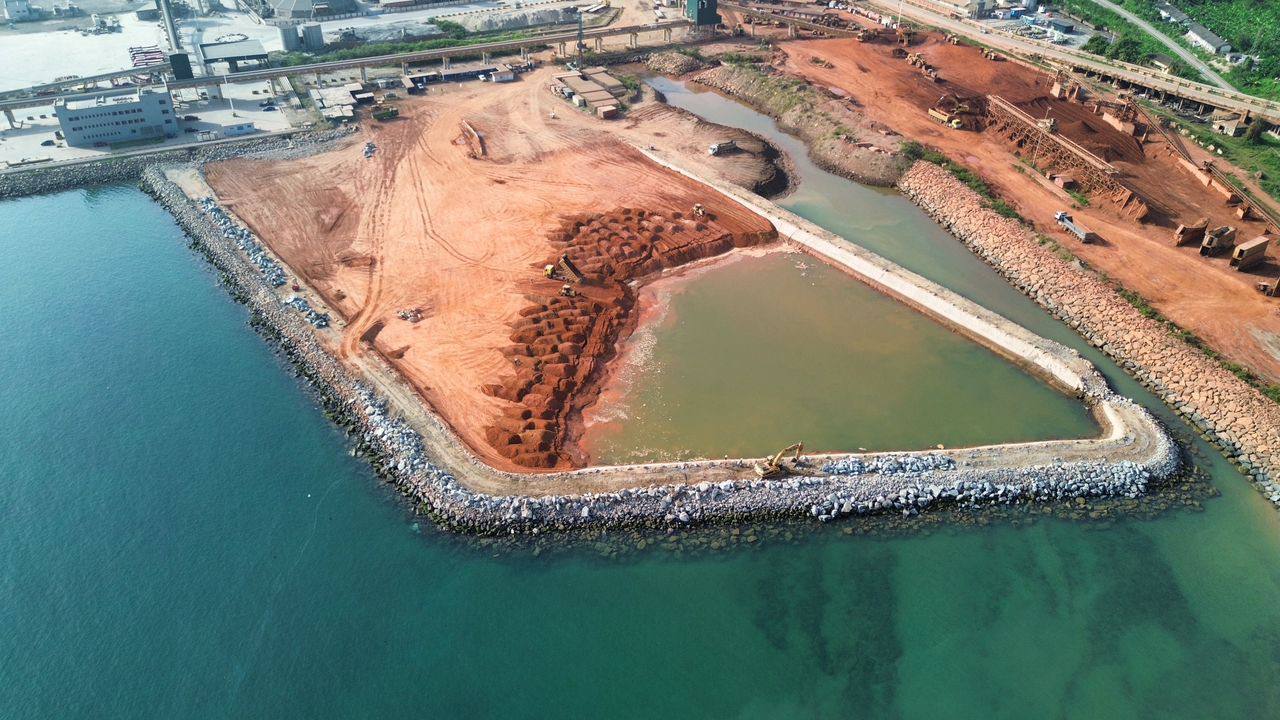

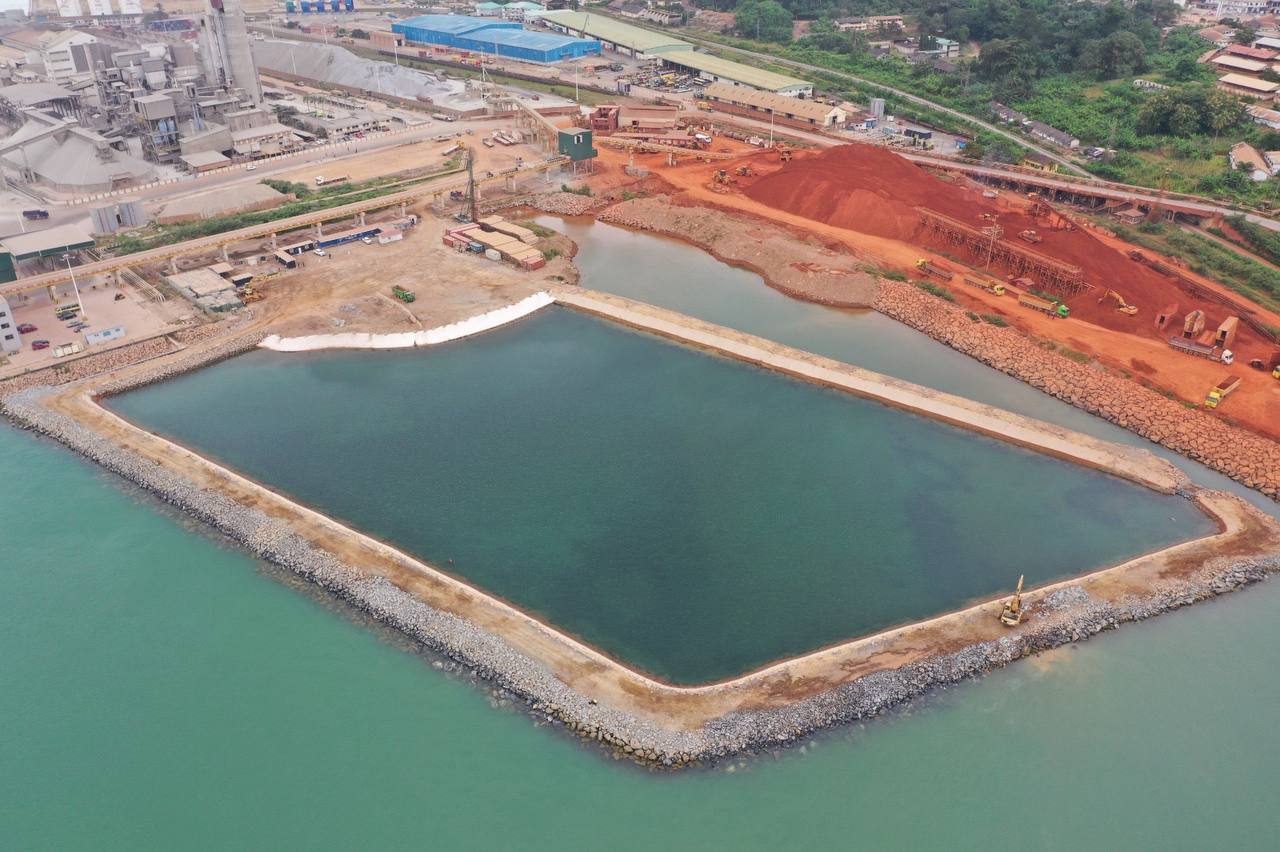

The revetment phase established the shoreline protection system, including 350 m of multi-layer revetment and 280 m of single-layer revetment, with core, underlayer, and armor protection works completed as part of the marine edge buildout.
Phase B

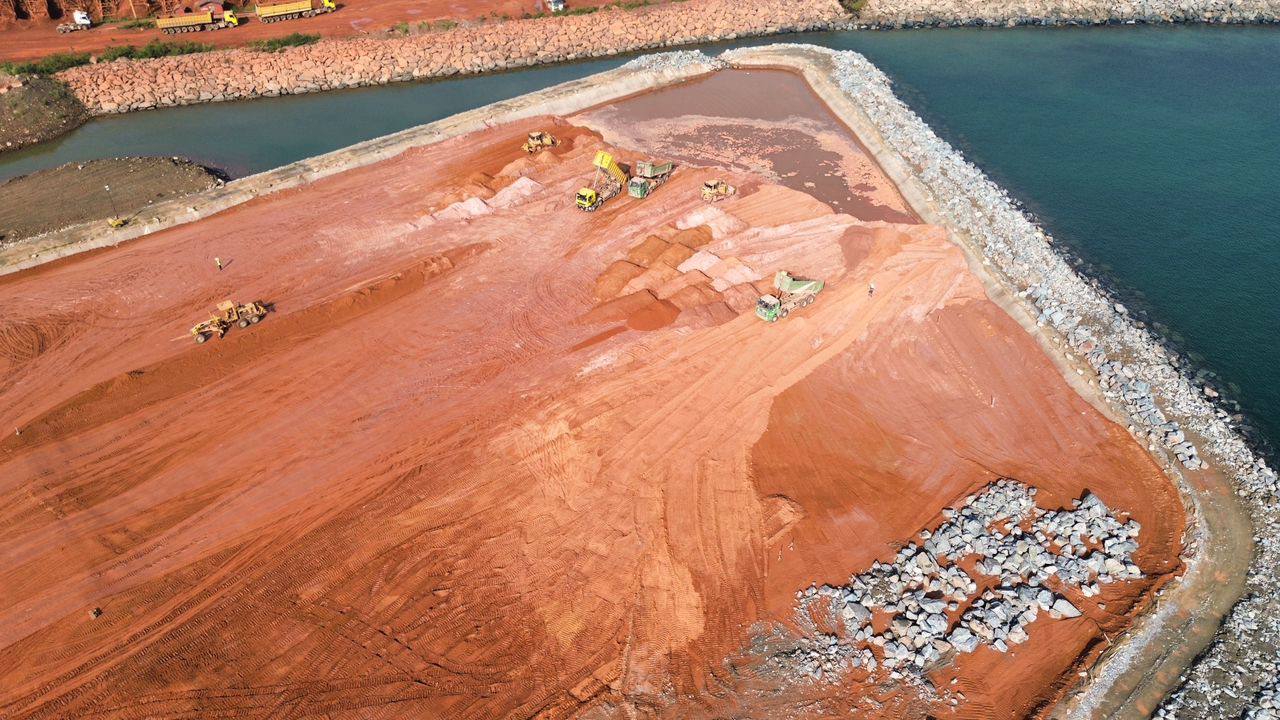

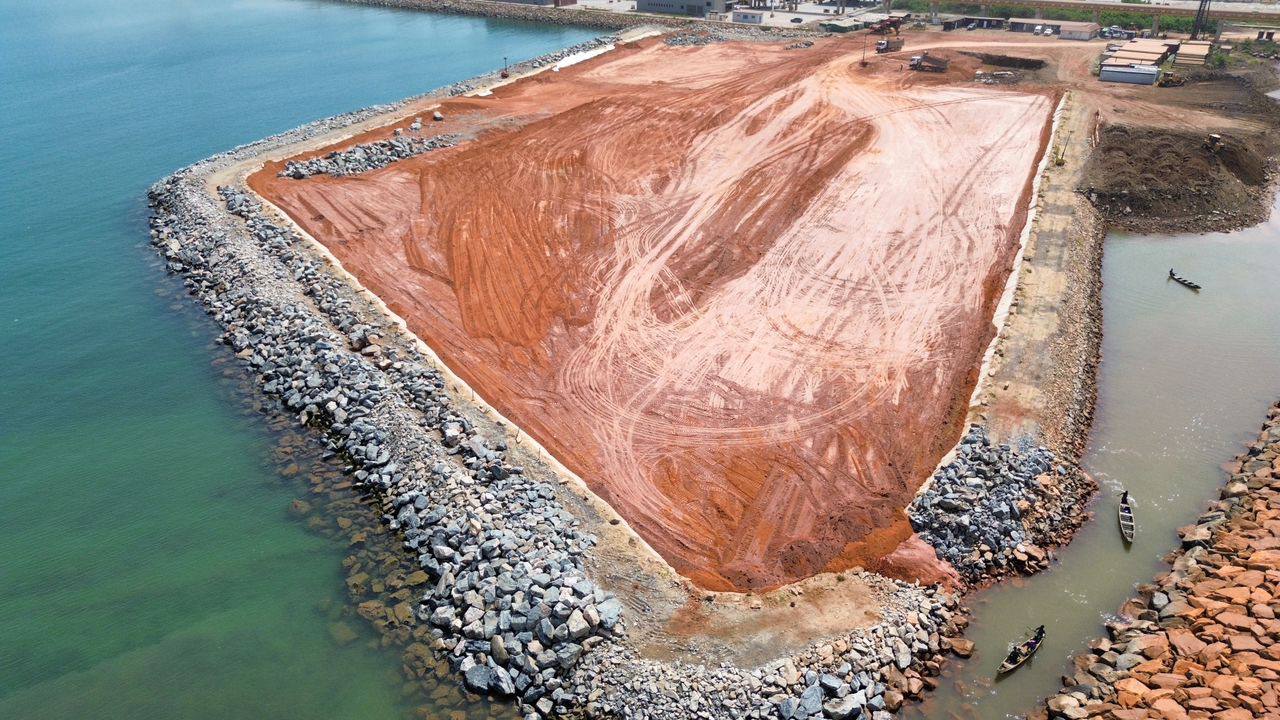

The reclamation phase brought the site above water and up to design level, creating a 30,000 m² area through laterite filling and controlled compaction, with infill volumes completed across the reclaimed platform.
Phase C

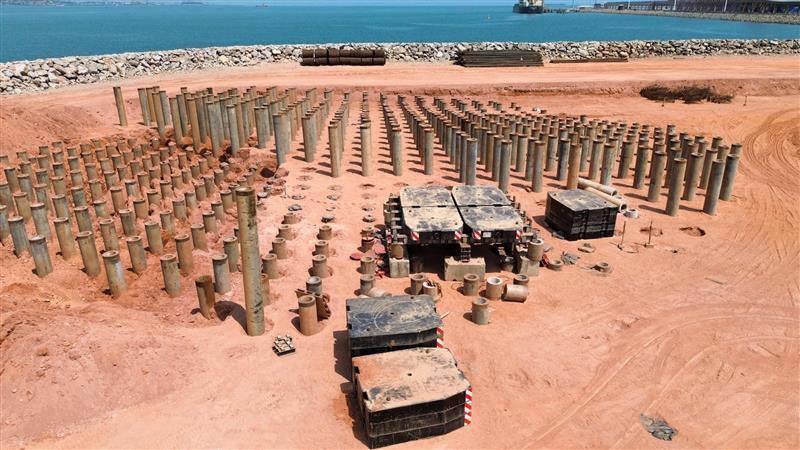

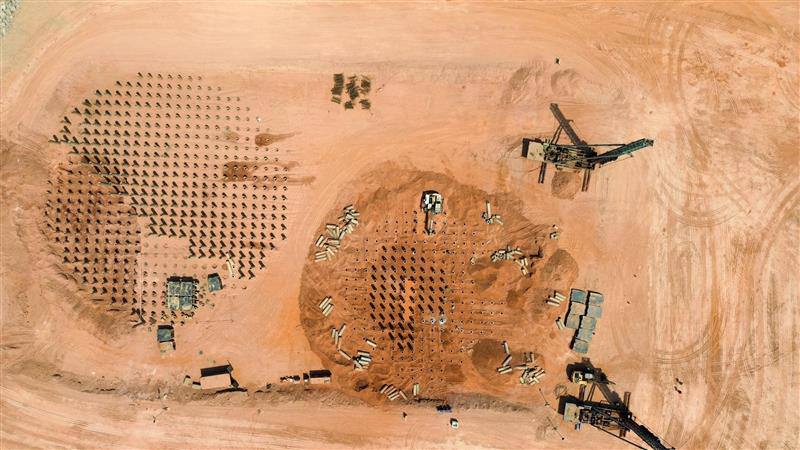

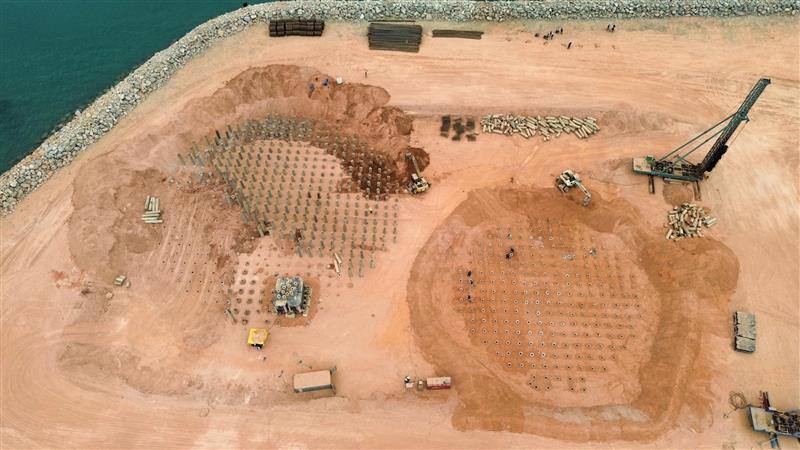

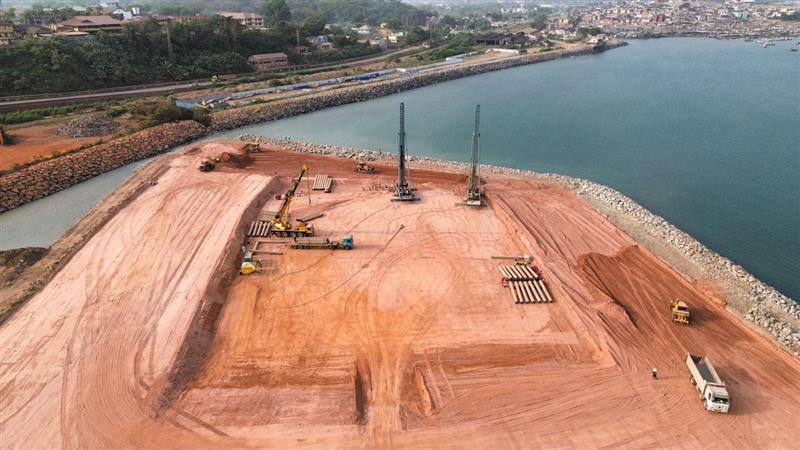

The piling phase established the structural support system for both butane and propane areas, using combined loading pile design to manage lateral and end-bearing demands across the terminal footprint.
Phase D

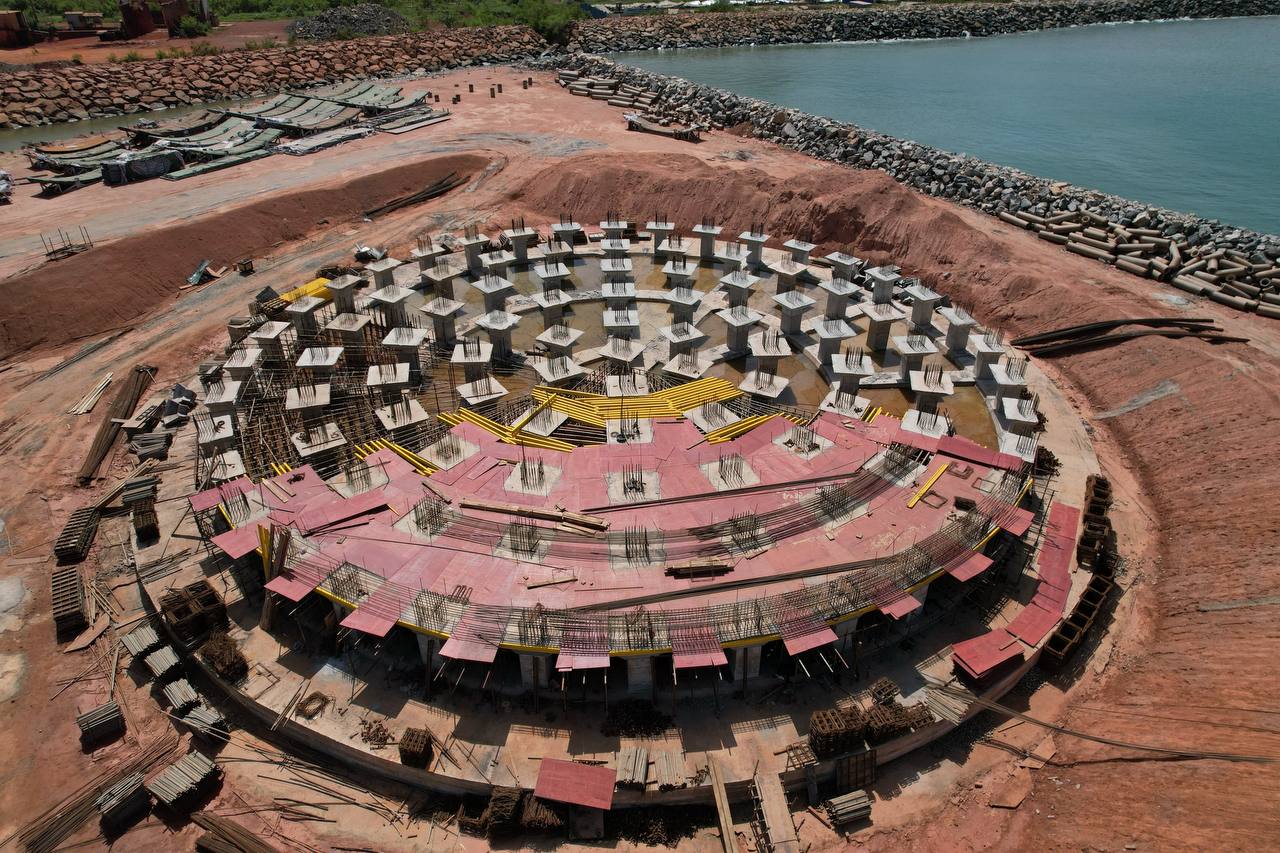

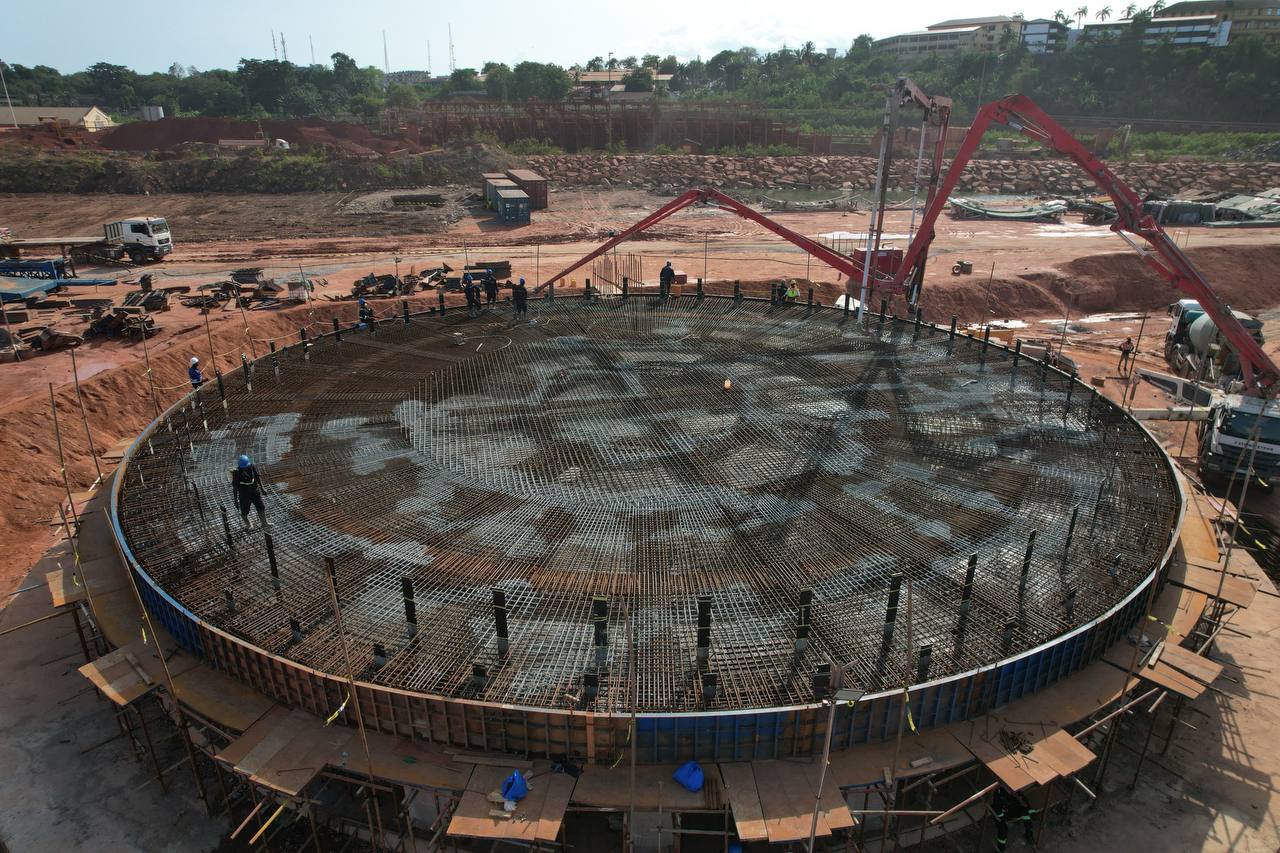

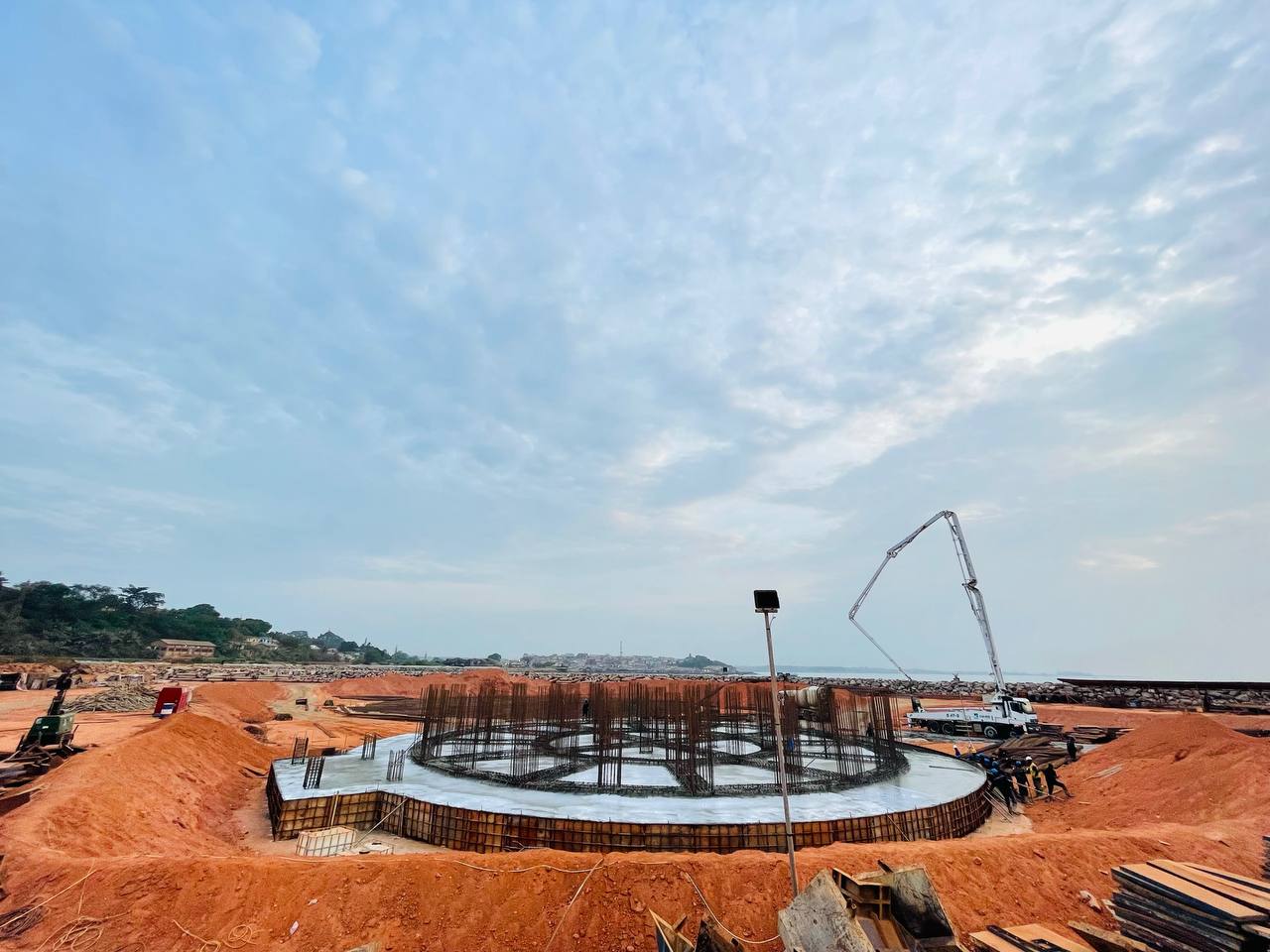

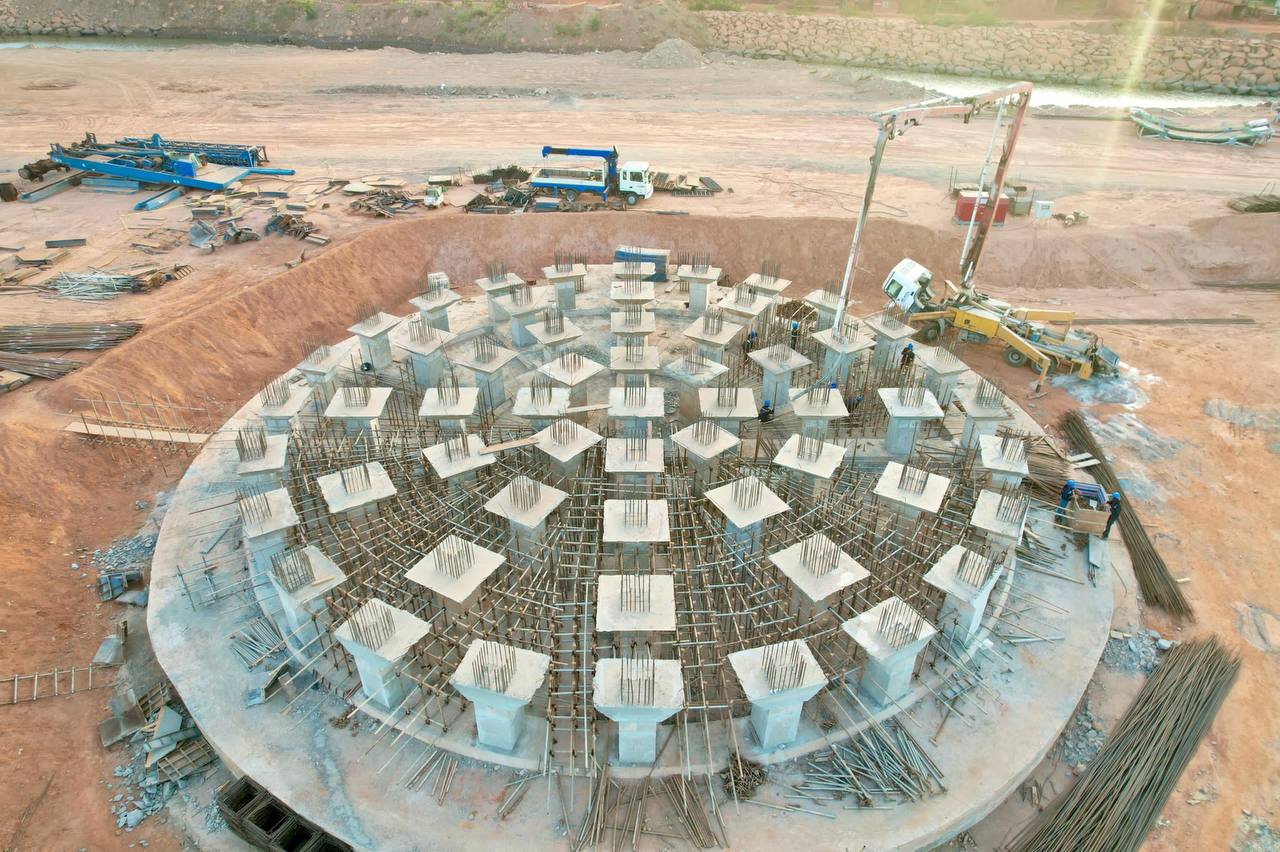

The concrete foundations phase formed the base supports for the cryogenic tank system, with reinforcement completed to engineering specification and structural pours executed for the support platforms.
Phase E

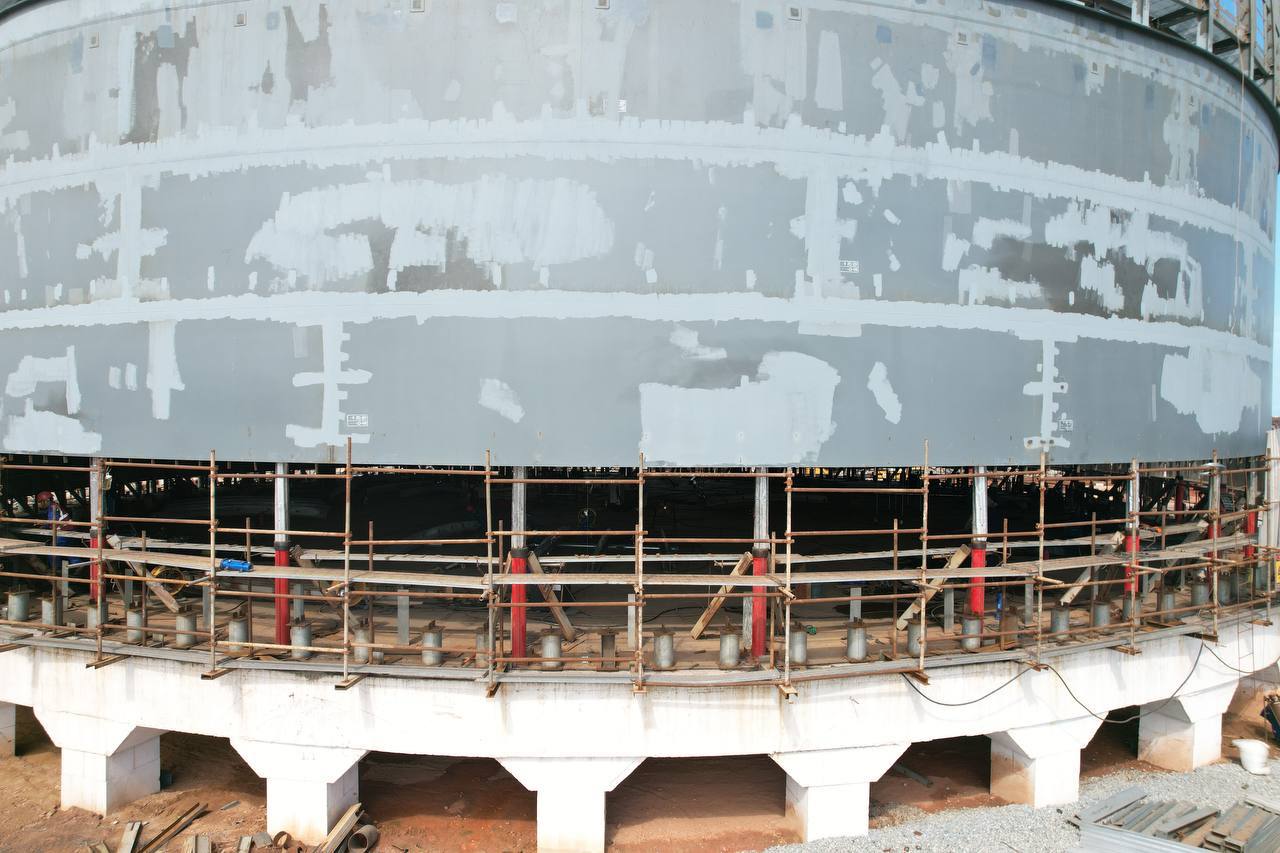

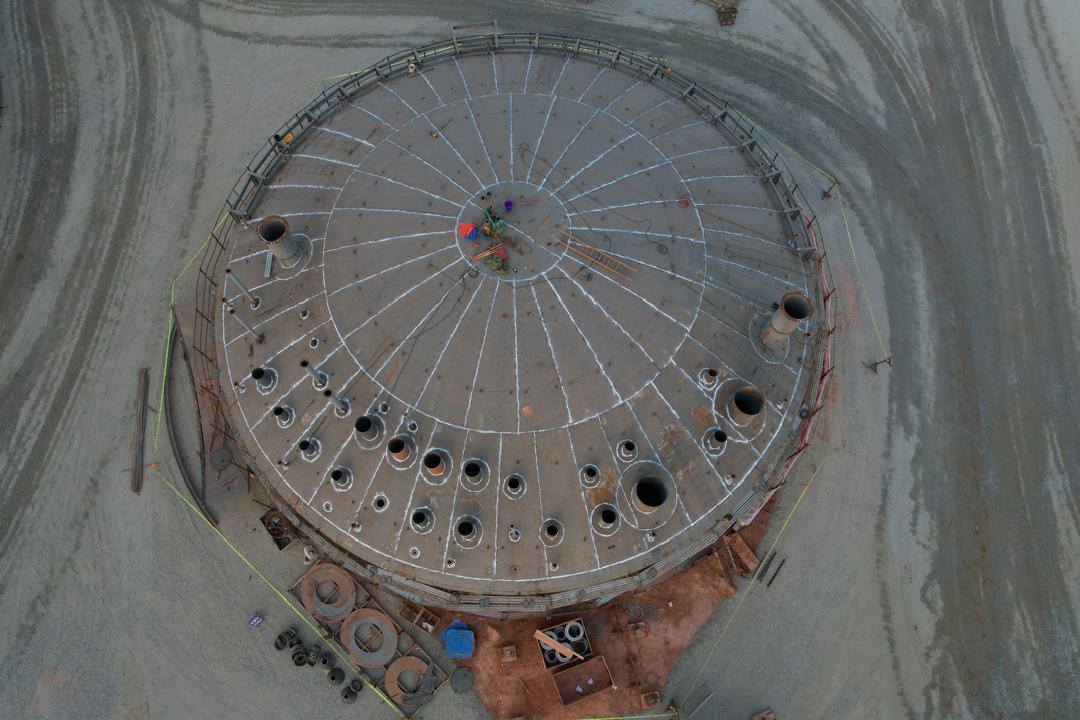

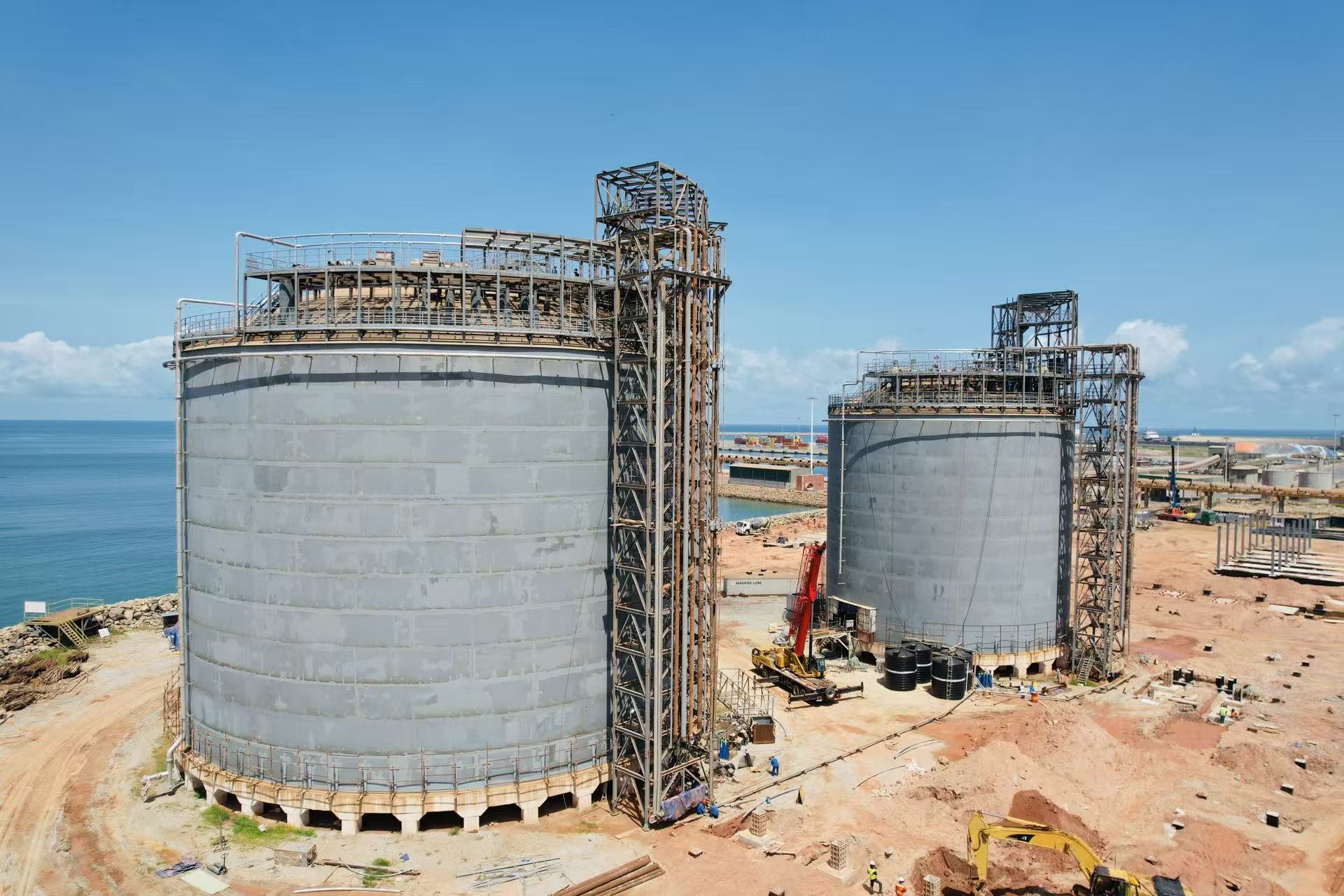

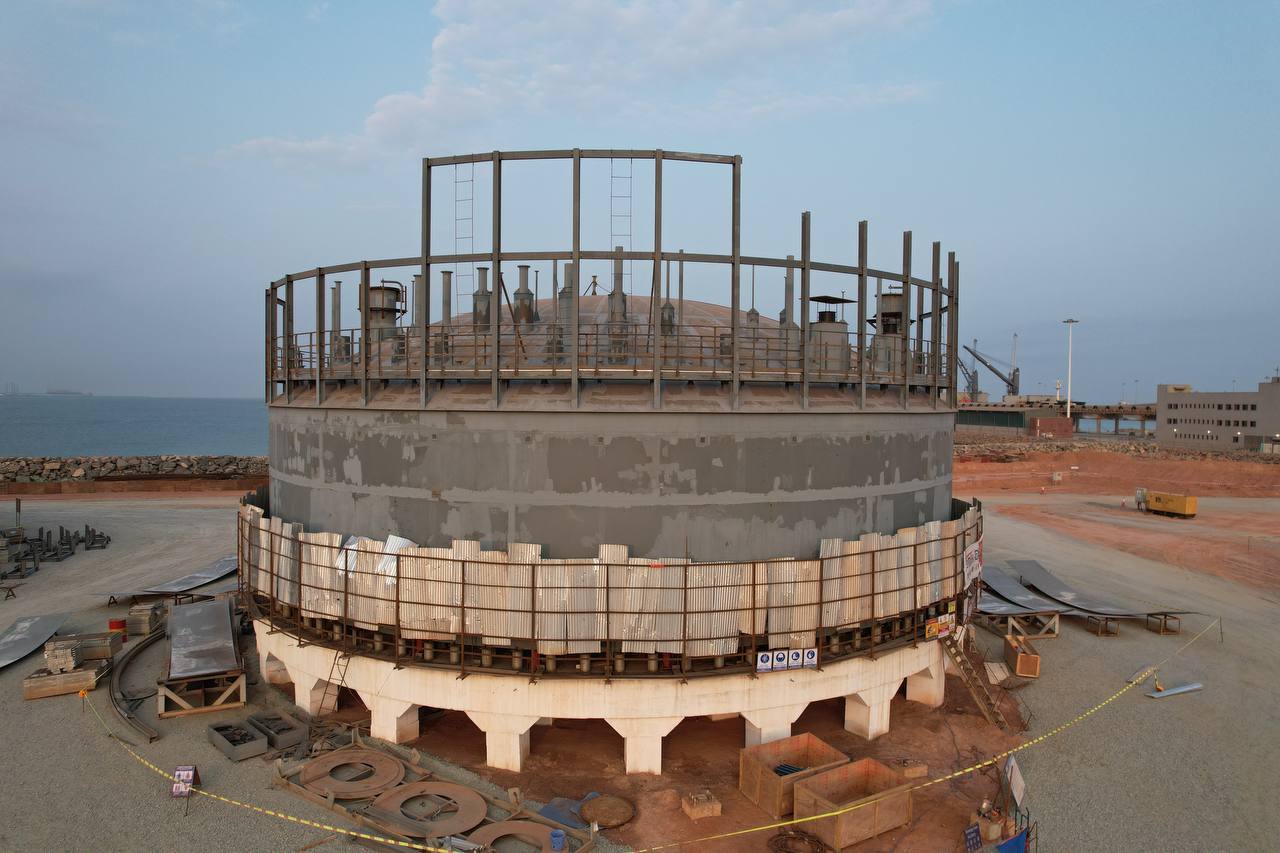

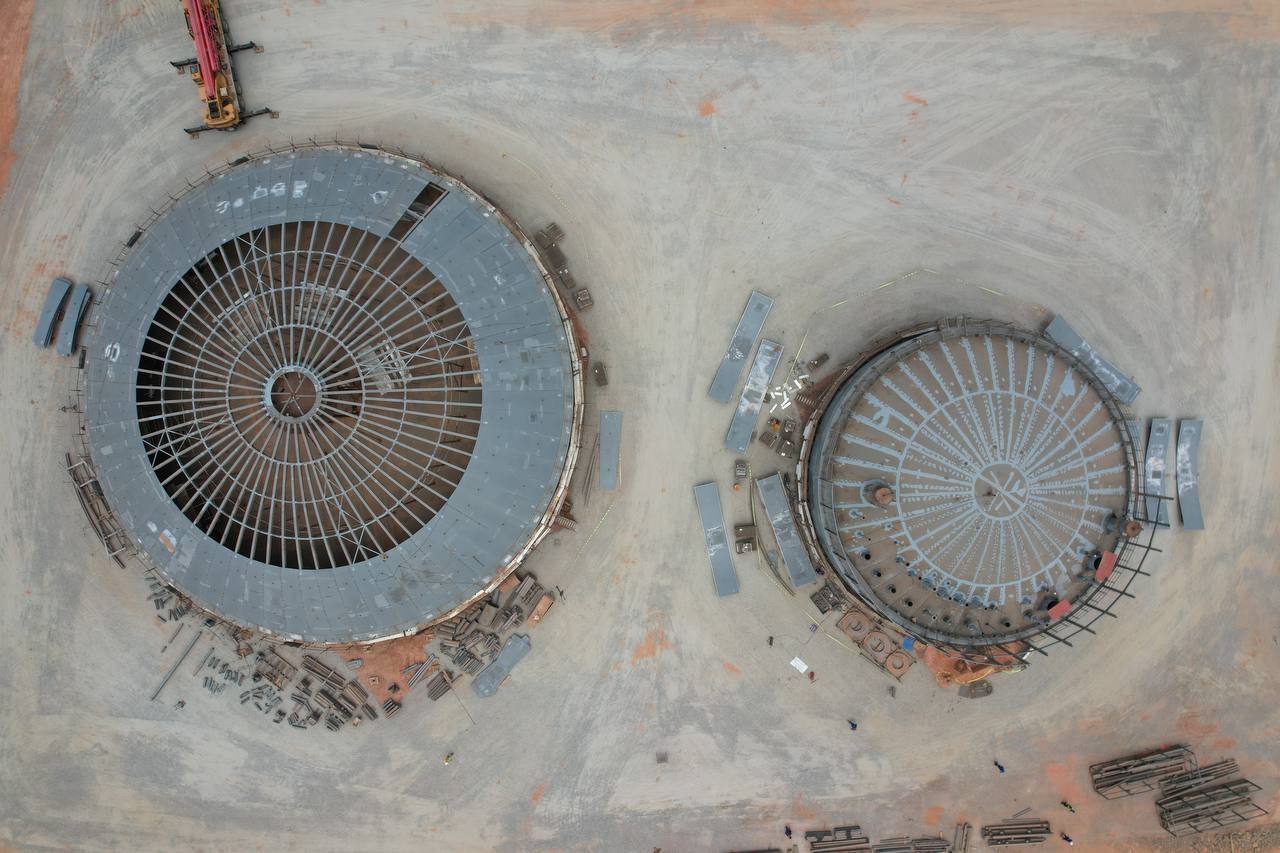

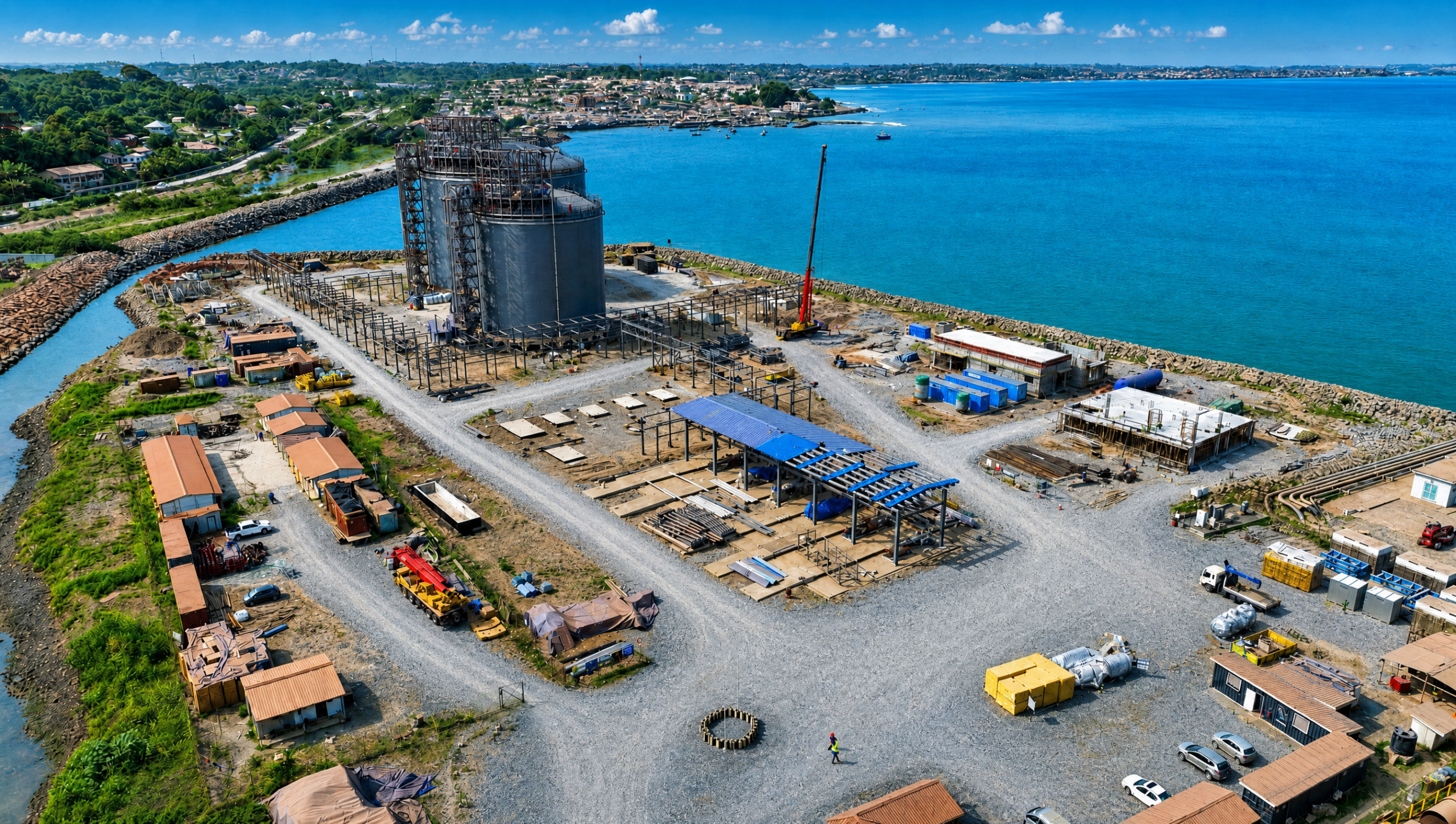

Cryogenic tank modules were fabricated on site and advanced through welding and pressure testing for both butane and propane storage systems, forming one of the most visually defining stages of the project.
Phase F

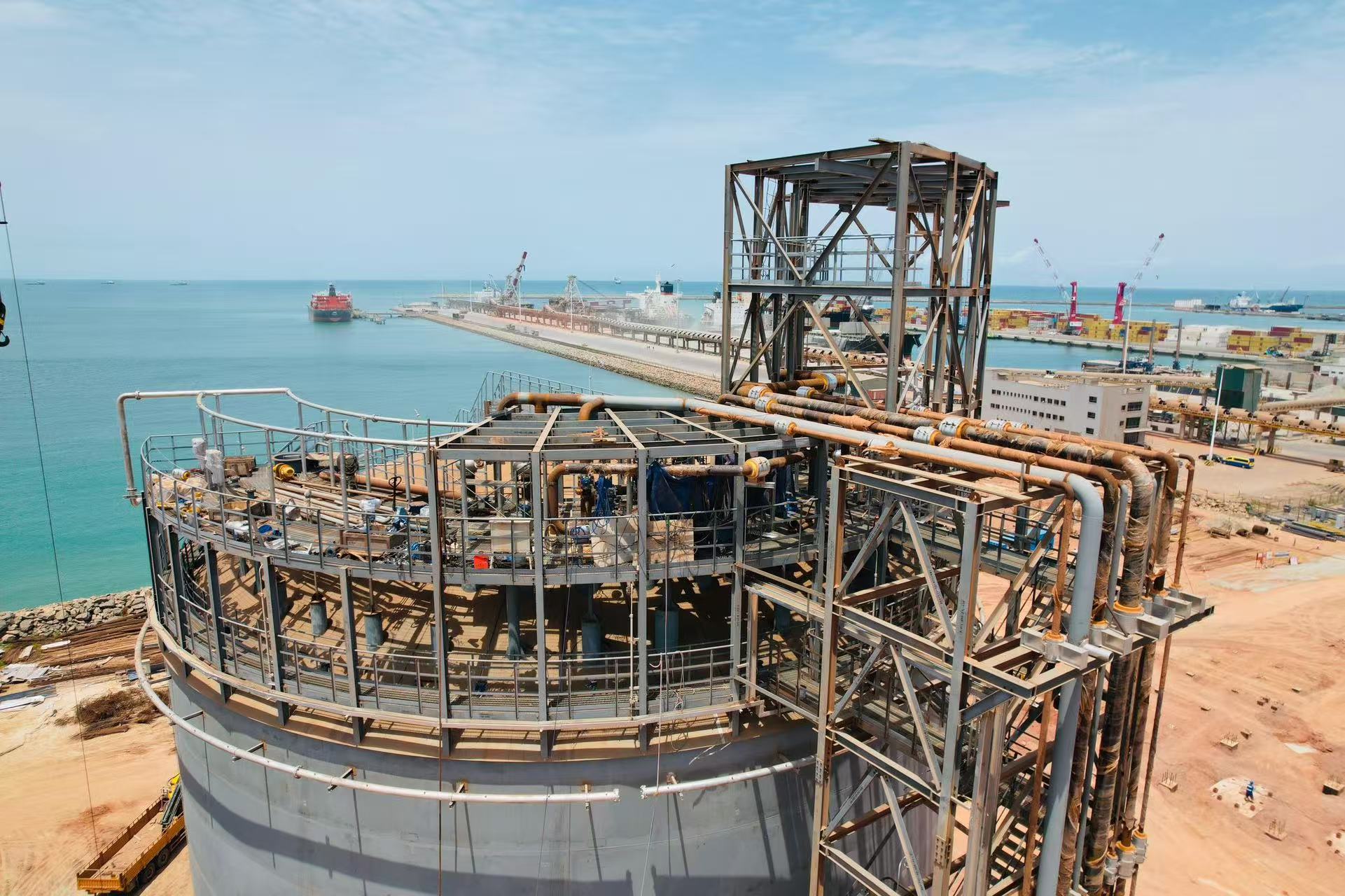

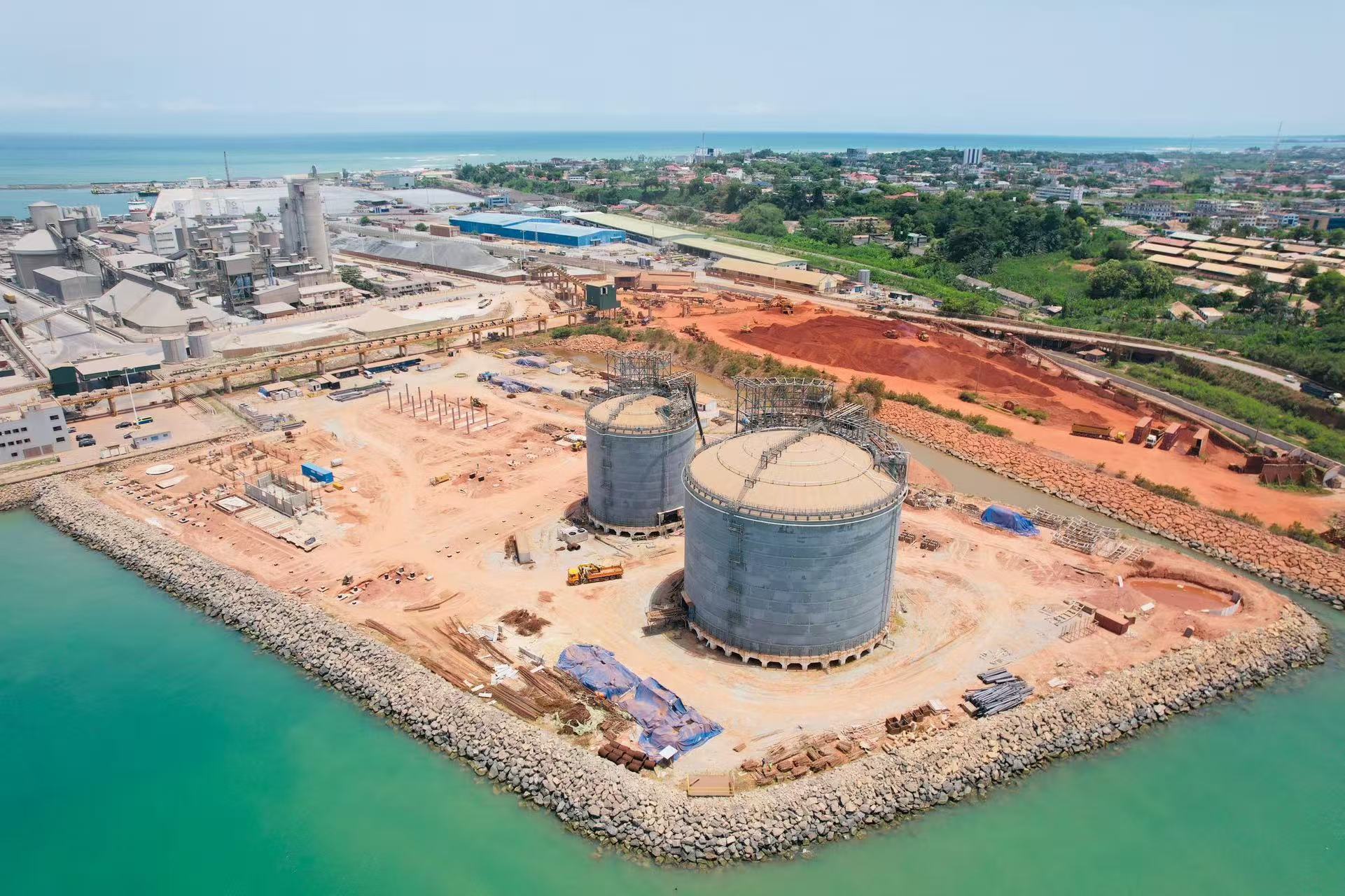

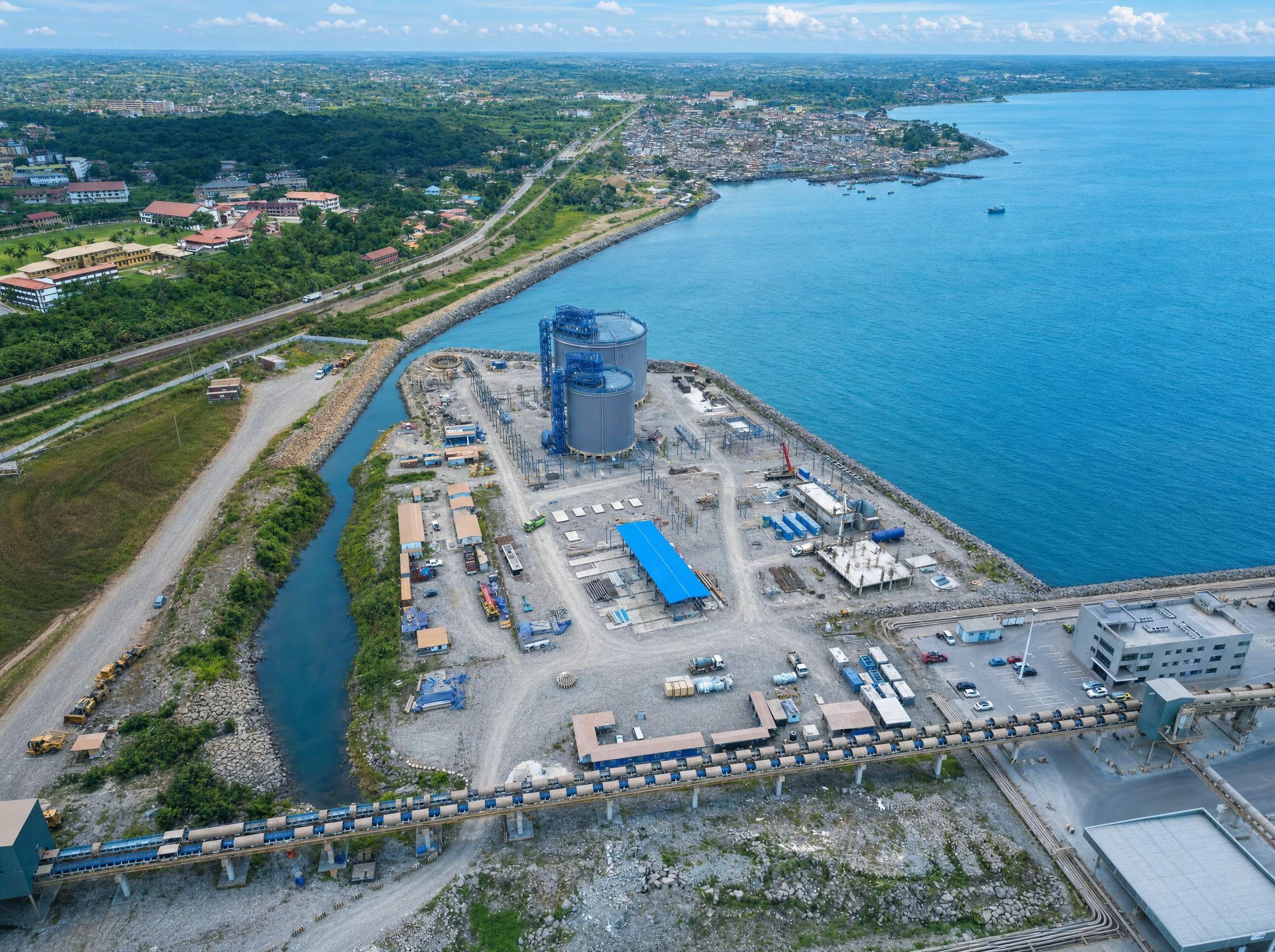

The installation phase brought together internal systems and operational infrastructure, including the aluminum ceiling, pump wells, internal piping, tower stairs, maintenance platforms, fire lines, and inner shell ring installation and welding.
System Overview
Next Steps
